Multi Site Signage Rollouts Rolling out signage across a dozen, fifty, or two hundred locations isn't a bigger version of ordering signs for one site. It's a coordination problem wearing a procurement costume. The part most programs underestimate isn't fabrication or shipping — it's ADA compliance.

Here's the risk: one non-compliant ADA sign at one site can trigger a delayed opening, a tenant complaint, or legal exposure that ripples across the entire program. Multiply that by dozens of jurisdictions, each with its own code quirks, and the exposure compounds fast.

This guide covers planning your rollout, making site-specific ADA decisions, navigating code variance, managing three separate approval chains, and choosing a signage partner who won't slow you down.

Key Takeaways

  • Standardized site surveys prevent the rework that kills timelines
  • Plan for state and municipal ADA rules beyond the federal baseline to avoid failed inspections
  • Manage brand, landlord, and code-authority approvals as three separate chains
  • A dependable ADA-compliant signage partner cuts rework and protects opening dates

What a Multi-Site Signage Rollout Involves

Rollout phases (survey, design, permitting, fabrication, install) don't happen one after another. They run concurrently across sites, which is exactly why coordination gets messy. Site 12 might be in permitting while Site 3 is already fabricating and Site 40 hasn't even been surveyed yet.

That concurrency demands named ownership. Without it, information gets lost between phases. At minimum, assign:

  • Site list owner — maintains the master roster and status of every location
  • Survey standard owner — ensures every site is measured the same way
  • Code/compliance research owner — tracks federal, state, and local requirements per jurisdiction
  • Brand relationship owner — manages design tolerance and sign-off with the brand team

Permit and code review timelines are the least controllable variable in the entire process. Research them earliest, not last.

Multi-site signage rollout phases showing concurrent survey design permit fabrication timeline

Rework on construction-related projects typically runs 2% to 20% of the total contract amount, according to the Construction Industry Institute. Incomplete upfront documentation is one of the biggest drivers.

Why Sequencing Matters

Front-load the permissive, easier jurisdictions first. This builds momentum and gives your team early wins. It also surfaces the hard sites (historic districts, restrictive landlords, unusual occupancy types) while there's still time to adjust before your hardest deadlines hit.

How Would You Decide the Site-Specific Signage for a Site?

Every site-specific decision starts with a standardized survey. That survey should capture:

  • Facade dimensions and mounting surface material
  • Power access, if illuminated signage is involved
  • Existing signage conditions (what's there, what needs removal)
  • Door swing direction and latch-side location

ADA-specific factors get assessed per site, not per program. Mounting height and location relative to the door frame, required tactile and Braille elements, and finish/contrast requirements all depend on what's actually at that location — not what worked at the last one.

Local rules stack on top of the federal ADA baseline:

  • Zoning and overlay districts can add permit steps the ADA never requires
  • Historic districts may need a Certificate of Appropriateness before any exterior signage permit moves forward
  • Landlord master sign programs often restrict materials the code itself never mentions

Interior Context Drives Sign Type

Whether a sign needs tactile and Braille elements depends heavily on context. Federal guidance draws a real distinction: permanent room-identification signs (restrooms, break rooms, mechanical rooms) generally require both visual and tactile treatment, while purely directional or informational signs only need visual compliance. Exit-stairway and exit-passageway doors trigger tactile identification regardless of room type, according to the Access Board's signage guidance.

Example: Two restaurant locations in the same city can still need different ADA sign specs. One may have a single-leaf restroom door with straightforward latch-side placement. The other, in an older building, may use a double door with two active leaves, which shifts placement to the wall right of the right-hand door.

That kind of site-by-site variance is why you should document an exceptions log per location. When decisions and reasoning are traceable, resubmissions and disputes get resolved in minutes instead of days.

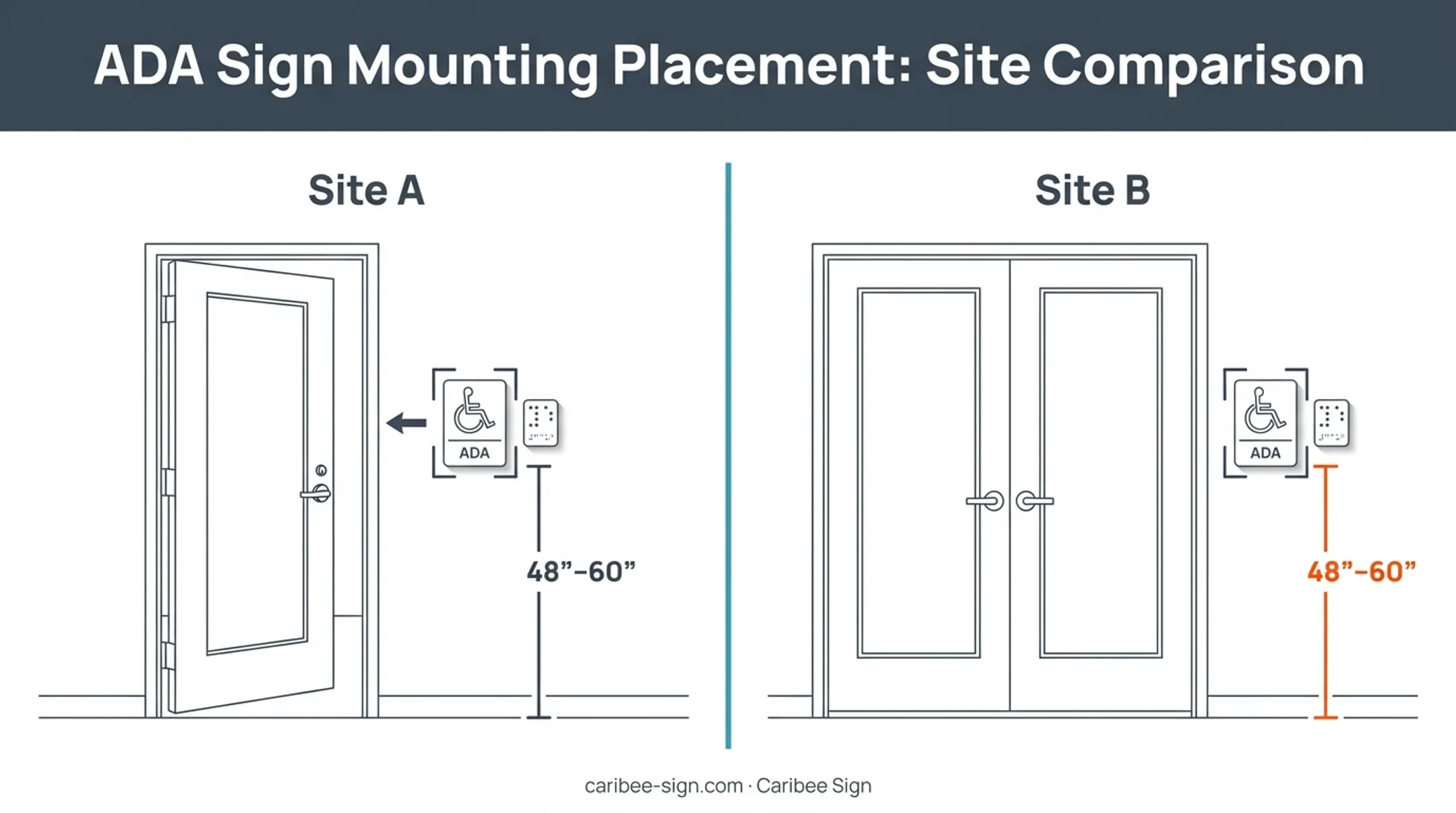

ADA restroom sign mounting placement differences for single-leaf versus double-door entries

ADA Compliance and Code Variance Across Multiple Locations

ADA is a floor, not a ceiling. The 2010 ADA Standards set federal minimums: raised characters between 5/8 inch and 2 inches tall, Grade 2 Braille positioned below text, and tactile characters mounted 48 to 60 inches above the finish floor, per ADA.gov's design standards.

States and municipalities routinely add to that baseline. Common variance points:

  • Character height and proportion requirements
  • Raised character and Braille specification details
  • Mounting location relative to the door
  • Finish, contrast, and glare requirements

California's 2025 Building Code, for instance, adds geometric symbols at toilet-room entrances mounted 58–60 inches high, plus specific "ALL-GENDER MULTI-USER" signage language for certain facilities. None of that appears in the federal baseline.

Extra layers show up beyond state code:

  • Historic and overlay districts that need separate approvals before permits move
  • Healthcare, education, and government sites with their own institutional standards
  • Campus or facility manuals that dictate sign types and mounting specs above ADA minimums

Those layers are why one brand-approved ADA design rarely fits every site. A sign that's fully compliant in Missouri might miss a mounting or symbol requirement in California.

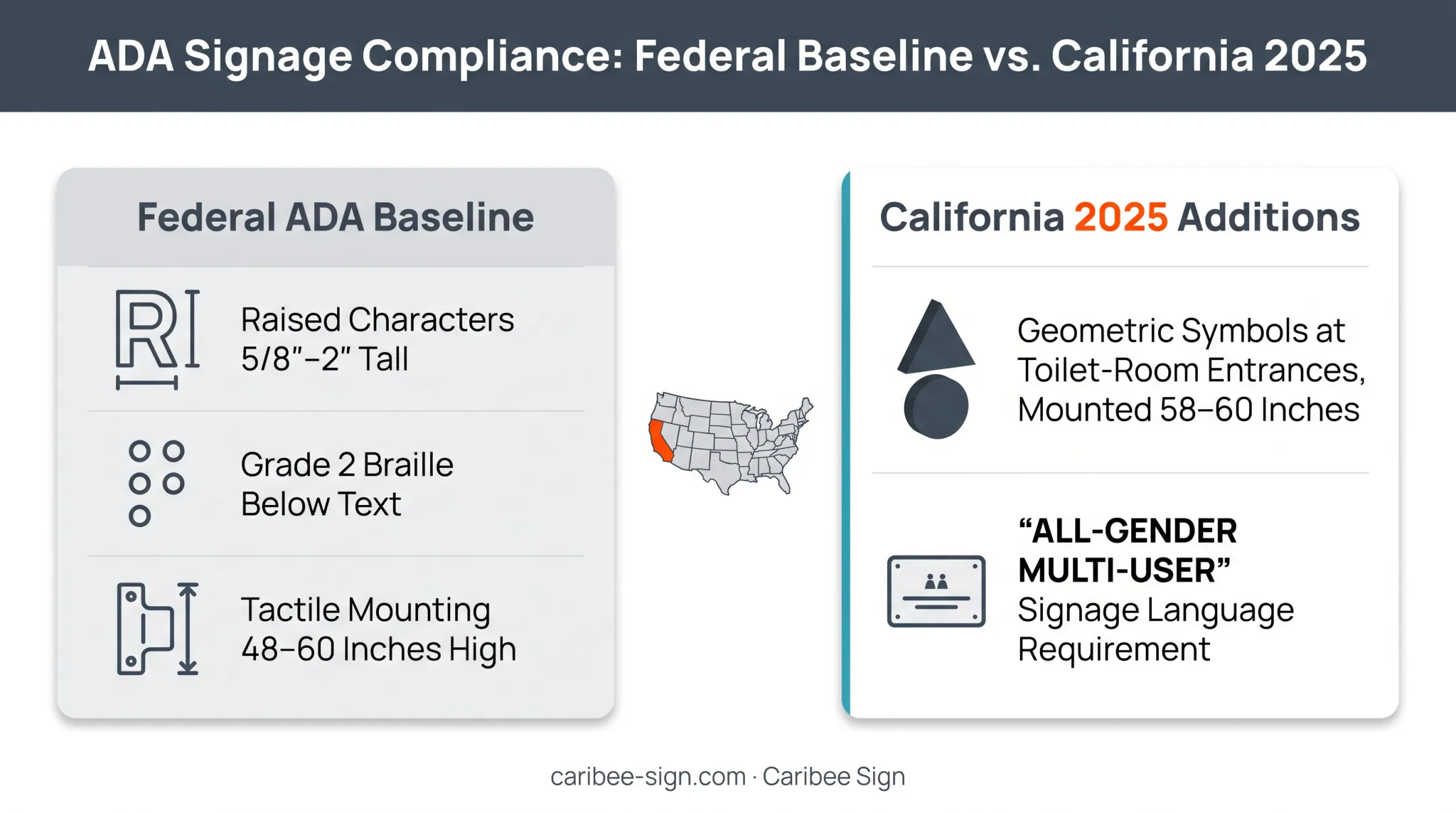

Federal ADA baseline versus California state code additional signage requirements comparison

Caribee Sign's products meet federal ADA requirements (raised tactile characters, Grade 2 Contracted Braille, appropriate contrast, and compliant mounting provisions), so sign companies get a consistent baseline to standardize around. Site-specific mounting and placement rules still need local verification.

Confirm requirements with the local authority having jurisdiction before finalizing designs. Codes change, and "it worked last year" isn't a defense.

The Three-Party Approval Chain

Three separate parties approve different aspects of a sign, and none of them share the same criteria:

  1. Brand standards teams — focus on identity consistency: logo usage, colors, and typography. Document tolerance for code-driven deviations early so a required Braille placeholder doesn’t become a last-minute conflict.
  2. Landlords/property managers — often enforce criteria stricter than code itself. Request those documents during the survey phase so they don’t surface after design is locked.
  3. Authority having jurisdiction (AHJ) — can force an installed sign back down. Consult them first.

A sign permit application may get both administrative approval (sign-code criteria) and design approval (aesthetic review), according to the International Sign Association. Design approval is more discretionary and can stretch timelines unpredictably.

Recommended sequencing: Establish the code and ADA compliance envelope first. Design within it. Then seek brand and landlord approval together, once you already know the design can't be rejected on compliance grounds.

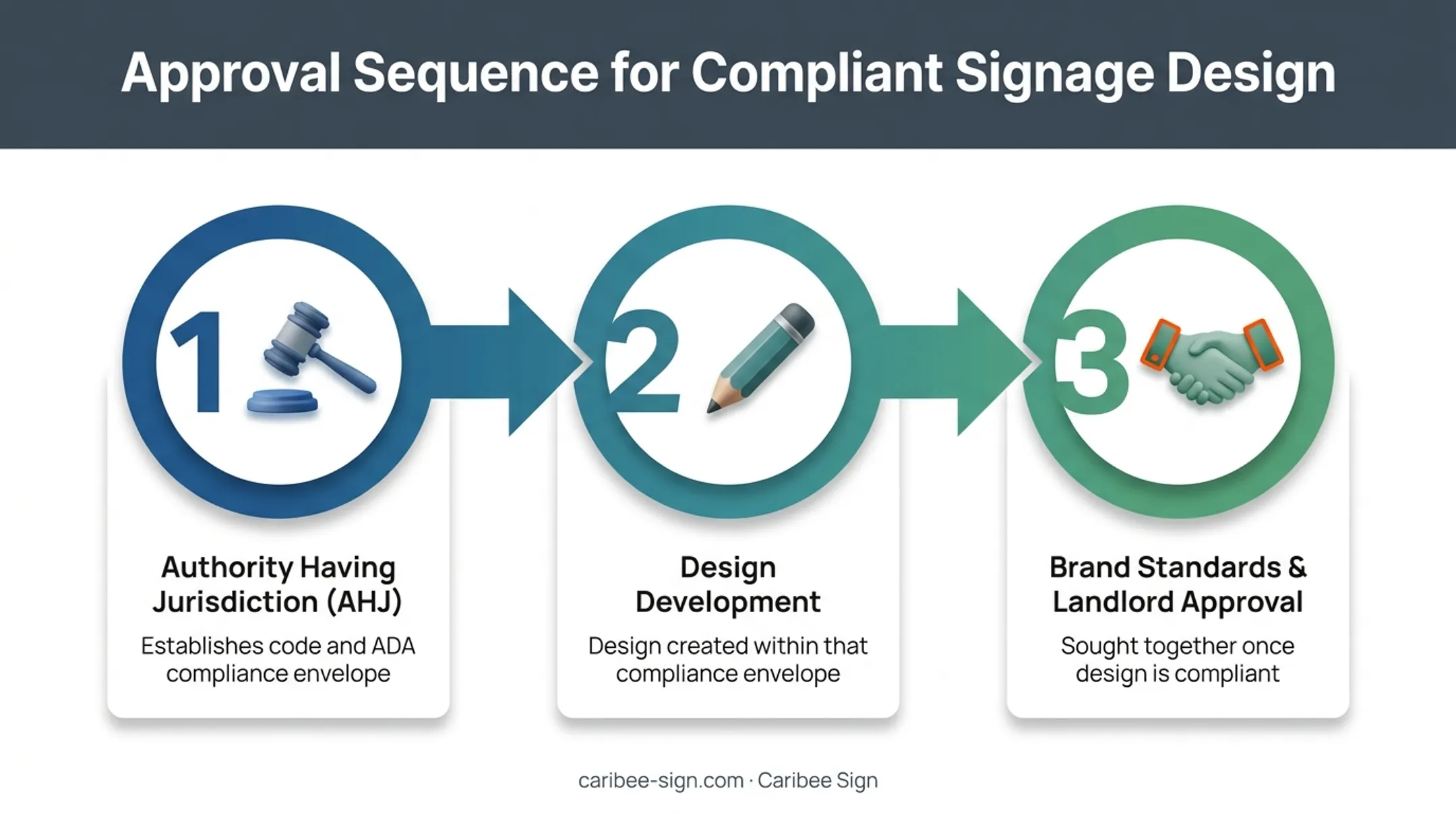

Three-party sign approval chain sequence from compliance to brand and landlord sign-off

Common Failure Modes and What They Cost

Three failure patterns show up repeatedly in multi-site programs:

  • Incomplete or inconsistent surveys — leads to re-fabrication and extra truck rolls when field conditions don't match what was documented
  • Late-discovered ADA or landlord requirements — forces redesign and resubmission cycles that eat weeks
  • Missed opening dates — the costliest outcome, since signage delays directly delay revenue-generating openings

A PlanGrid/FMI survey of nearly 600 U.S. construction leaders found that inaccurate, inaccessible, or incompatible project data caused 48% of U.S. rework, totaling more than $31.3 billion annually. Teams surveyed spent nearly 12% of their week resolving conflicts caused by bad data.

These figures are construction-wide, not signage-specific, but the mechanism is identical: incomplete information upfront becomes expensive correction downstream.

Choosing a Reliable ADA Signage Partner for Multi-Site Programs

Sourcing signage per site, from whoever's closest or cheapest that week, multiplies inconsistency. A dependable go-to partner for ongoing ADA signage needs removes that variable entirely.

Caribee Sign works exclusively with sign companies and trade professionals, producing ADA-compliant signage in-house. Every order includes:

  • CNC routing
  • Laser engraving
  • Grade 2 Braille translation

That in-house control matters when a program needs the same quality standard across 50 job sites, each at a different address.

One trade partner, Hugh-Carolina Sign Co., put it simply: Caribee is their "go-to" company for ADA signage needs, citing responsiveness and products that consistently meet requirements. That consistency protects brand uniformity and legal compliance at the scale where both are hardest to hold together.

Frequently Asked Questions

How do you decide site-specific signage for each location?

Site-specific decisions rely on standardized survey data, ADA requirements tied to door type and path of travel, and any local code or landlord restrictions layered on top of the federal baseline. No two sites should be assumed identical until the survey confirms it.

What is the biggest challenge in managing signage across multiple locations?

Inconsistent surveys and varying local code or ADA requirements top the list. When survey data isn't standardized, compliance gaps surface late — right when they're most expensive to fix.

Does ADA compliance vary by state?

Federal ADA sets the baseline, but states and municipalities can impose additional requirements. California's 2025 code additions around toilet-room symbols are one clear example.

How can sign companies avoid ADA compliance mistakes in a rollout?

Use standardized surveys, verify requirements per site rather than assuming brand-wide consistency, and work with a specialized ADA signage partner who builds compliance into the product from the start.

Who is responsible for ADA sign compliance at each site?

The property owner or tenant carries ultimate legal responsibility, though lease terms can divide performance duties between them. Signage partners and sign companies help ensure the physical product meets requirements.

How long does a multi-site ADA signage rollout typically take?

Most multi-site rollouts run 8 to 16 weeks from design completion to occupancy. Timeline hinges on site count, when surveys start, and permitting—which is usually the least predictable variable.
